Short answer: there is no defensible universal price for a 10,000 sq ft climate-controlled greenhouse. The useful budget is a scope model that separates the structure, environmental systems, crop system, site work, utilities, logistics, installation and commissioning. Two quotations are comparable only when they use the same location, crop criteria, design weather, responsibilities and acceptance tests.
Start with the production brief, not a price per square foot
A 10,000 sq ft footprint does not define the installed project. Record the usable crop area, crop and growing method, production months, day and night environmental limits, target market, labor plan and post-harvest needs. The same external area can contain very different benching, hydroponic, packing and service layouts.
Use project coordinates and an hourly weather file. Heating, ventilation, evaporative cooling, dehumidification and lighting duties depend on the actual outside conditions and crop limits. A price borrowed from another region can omit the equipment that controls the buyer's highest-risk weather period.
Build the capital budget by responsibility
| Cost group | Items to define | Evidence to request |
|---|---|---|
| Site and civil work | Survey, geotechnical information, clearing, grading, drainage, foundations, roads and equipment pads | Site plan, levels, foundation design basis, quantities, exclusions and local contractor responsibility |
| Structure and envelope | Frame, gutters, covering, doors, vents, insect screens, thermal screens, seals and fastening systems | Design loads, material specifications, drawings, net vent area, replacement access and warranty terms |
| Climate equipment | Heating, circulation, exhaust, inlets, pads, pumps, shade, fog, dehumidification and controls | Load calculations, equipment duty, motor list, control sequence, alarms and backup action |
| Crop and water systems | Benches or rows, irrigation, filtration, storage, dosing, drainage, disinfection and water treatment | Water analysis, zone flow and pressure, material schedule, drain route and commissioning tests |
| Electrical and controls | Incoming service, panels, cabling, sensors, controller, network, generator interfaces and data records | Load list, single-line diagram, I/O schedule, user roles, safe states and test script |
| Delivery and handover | Freight, insurance, duties, unloading, installation, supervision, training, spares and documentation | Delivery term, package list, responsibility matrix, schedule, acceptance record and restoration parts |
Separate supply price from installed project cost
A structure-only offer may exclude foundations, local labor, electrical distribution, water storage, heating fuel infrastructure, controls integration and commissioning. Ask every bidder to mark each line as included, excluded, buyer supplied or provisional. Record the delivery term and destination because freight, duties and site handling can change the comparison.
Provisional allowances need a quantity and a later adjustment rule. A single unlabeled contingency does not show whether the risk comes from ground conditions, utility capacity, imported equipment, exchange rates or an unfinished crop-system design.
Size climate systems from loads
The University of Vermont's greenhouse heat-loss guidance starts with dimensions, covering, location and the required indoor temperature. UF/IFAS greenhouse design guidance likewise treats the structure, covering and machinery as one regional design problem. These are sizing inputs, not optional details to add after a frame price is accepted.
Request peak and part-load calculations for the agreed design conditions. The document should state envelope area and properties, infiltration assumption, solar and internal gains where applicable, ventilation duty and equipment margin. For cooling, confirm the net opening after screens or the fan and pad duty at the site's design air conditions.
Model operating cost from measured units
Do not accept one monthly utility figure without its assumptions. List each energy source, water, labor, consumables, replacement parts, sanitation, testing and planned maintenance. Model operating hours or monthly consumption from the equipment schedule and production calendar, then apply the buyer's local tariffs.
Keep crop revenue outside the supplier's construction price comparison. Yield, grade, packout, selling price, market access and crop loss need their own evidence and sensitivity cases. A greenhouse quotation can support a financial model, but it cannot prove a payback period by itself.
Compare quotations on the same baseline
- Issue one site, crop, weather, utility and responsibility brief to all bidders.
- Normalize area as external footprint, gross covered area and usable crop area.
- Compare structure, envelope, systems, crop equipment and civil work as separate groups.
- Mark exclusions, provisional sums, local supply, taxes, freight and installation assumptions.
- Review energy and water duties against the calculation inputs and equipment schedule.
- Price required spares, training, software access, documentation and seasonal commissioning.
- Keep a contingency owned by named risks rather than a generic percentage alone.
Information to send with a 10,000 sq ft greenhouse RFQ
- Coordinates, altitude, site plan, levels, access, drainage and available expansion land.
- Hourly weather file and structural design criteria required by local code.
- Crop, growing system, row or bench layout, canopy height and production calendar.
- Day and night temperature, humidity, light and root-zone operating boundaries.
- Water analysis, source capacity, storage, discharge route and sanitation requirement.
- Electrical supply, fuel, backup power, network and utility tariff assumptions.
- Required structure, covering, screens, vents, climate, irrigation and control systems.
- Local and imported responsibilities, delivery term, installation and permit scope.
- Commissioning conditions, pass criteria, training, manuals, spares and service access.
Related CFGET planning pages

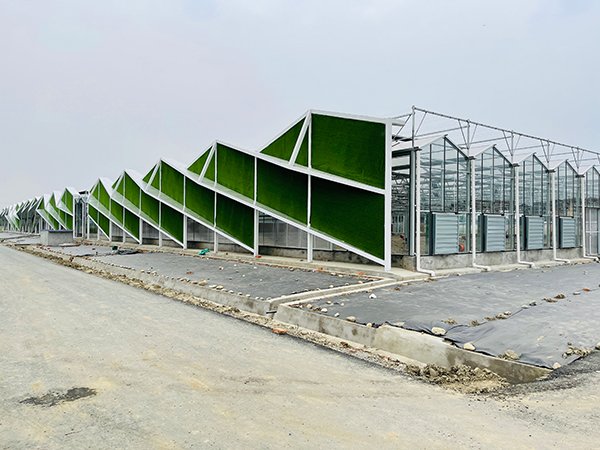

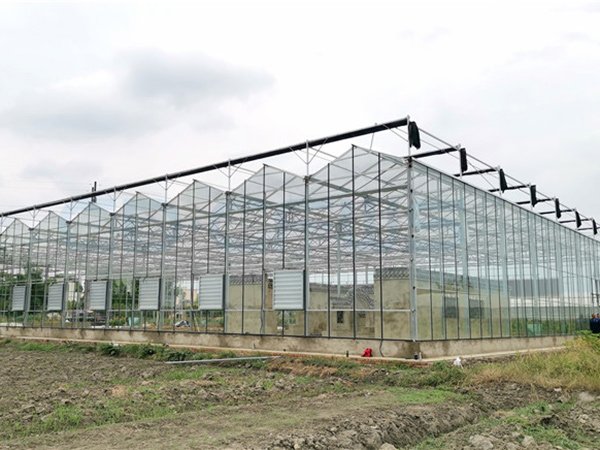

Use the greenhouse construction cost scope to compare budget categories. The commercial greenhouse planning guide covers site and responsibility inputs. Review existing CFGET greenhouse projects for structural and system context, without treating photographs as proof of performance or price.
Technical references
- University of Vermont Extension: calculating greenhouse and high-tunnel heat loss
- University of Florida IFAS: regional greenhouse design considerations
- University of Florida IFAS: fan and pad greenhouse cooling systems
Preparing a 10,000 sq ft greenhouse budget? Send CFGET the site, crop, weather, utilities, layout and responsibility matrix. The quotation can then show included scope, exclusions and acceptance evidence.
